Production equipment move to a fourth-floor installation area in the Czech Republic

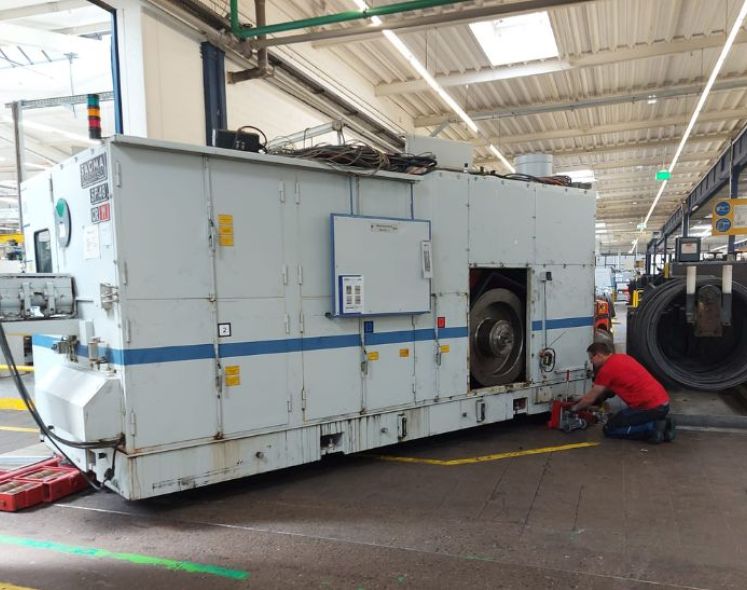

Unloading relocated production equipment and moving it to a fourth-floor installation area using 5-tonne forklifts and two 55-tonne mobile cranes.

République tchèque
Germany

Moving relocated production equipment from unloading point to a fourth-floor installation area

A global electrical-components manufacturer was relocating production equipment from Germany to its Trutnov plant in the Czech Republic. A local engineering company dismantled the machinery in Germany; Beck & Pollitzer’s scope began at the Czech destination.

The principal task was to unload the equipment and move it to the fourth-floor installation area, with several operations identified as high risk.


Risk documentation, 5-tonne forklifts and twin 55-tonne cranes

Before work started, the Czech team held a health and safety meeting covering the planned sequence. Risk assessments, method statements, lifting plans, training records and applicable licences were presented before the handling work began.

Seven operatives completed 528 project hours using 5-tonne forklifts and two 55-tonne mobile cranes to unload and move the equipment to the fourth floor.

Pre-start health and safety meeting
Risk assessments, method statements and lifting plans prepared
Equipment unloaded at the Czech destination
Internal movement to the fourth-floor installation area
5-tonne forklifts and two 55-tonne mobile cranes used
Seven operatives delivered 528 project hours
Pre-start health and safety meeting
Risk assessments, method statements and lifting plans prepared
Equipment unloaded at the Czech destination
Internal movement to the fourth-floor installation area
5-tonne forklifts and two 55-tonne mobile cranes used
Seven operatives delivered 528 project hours
Pre-start health and safety meeting
Risk assessments, method statements and lifting plans prepared
Equipment unloaded at the Czech destination
Internal movement to the fourth-floor installation area
5-tonne forklifts and two 55-tonne mobile cranes used
Seven operatives delivered 528 project hours
Pre-start health and safety meeting
Risk assessments, method statements and lifting plans prepared
Equipment unloaded at the Czech destination
Internal movement to the fourth-floor installation area
5-tonne forklifts and two 55-tonne mobile cranes used
Seven operatives delivered 528 project hours
  • Pre-start health and safety meeting
  • Risk assessments, method statements and lifting plans prepared
  • Equipment unloaded at the Czech destination
  • Internal movement to the fourth-floor installation area
  • 5-tonne forklifts and two 55-tonne mobile cranes used
  • Seven operatives delivered 528 project hours

Destination handling scope completed safely and on time

The Czech handling and relocation scope was completed safely and on time after 528 project hours.

Project hours
528
Team
7 operatives
Forklifts
5 tonnes
Mobile cranes
2 x 55 tonnes
Destination
fourth floor
Project Details
  • Client: Electrical components manufacturer
  • Location: Germany to Trutnov, Czech Republic
  • Sector: Other Industries
  • Programme: Production equipment offloading and internal relocation

Related Projects

Beck & Pollitzer Industrial Intelligence™

Industrial insight drawn from real-world delivery. Explore reports, articles and expert perspectives on the challenges shaping modern manufacturing and industrial programmes.
What manufacturers should consider before relocating production →
8 min

What manufacturers should consider before relocating production →

5 min read

What manufacturers should consider before relocating production →

5 min read

Your next project starts here

Whether you’re exploring an opportunity, planning a facility or preparing for installation,
our specialists can help you take the next step with confidence.
This site is registered on wpml.org as a development site. Switch to a production site key to remove this banner.
