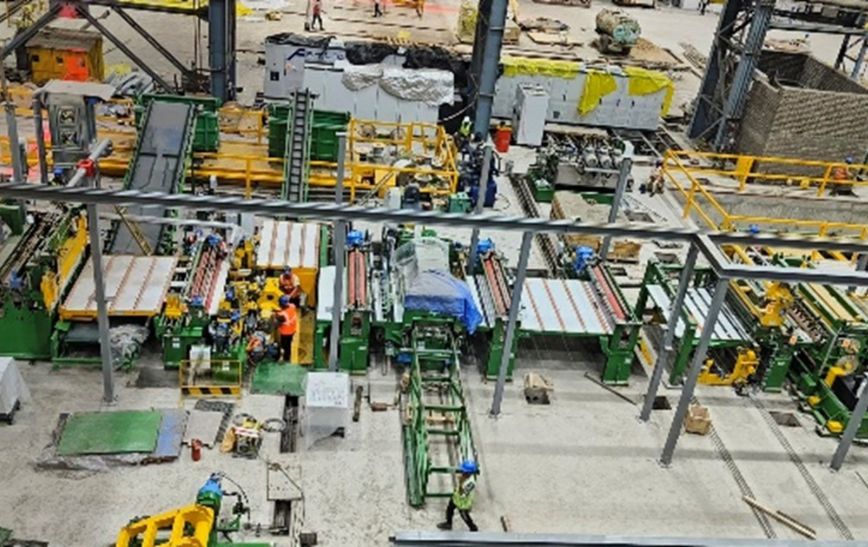

Installing over 6,250 tonnes of equipment and 375 km of electrical cabling for a new metals production facility.

Installing a new brownfield metals facility at exceptional scale and precision
Our team in India supported a metals manufacturer with the mechanical, electrical and piping installation for a new brownfield Cold Rolling Mill and Finishing Line facility. The scope covered the Cold Rolling Mill, Thick Gauge Slitter, Thin Gauge Slitter, Roll Grinder, Coil Packaging Line, High Speed EOT Cranes and multiple Annealing Furnaces, each demanding highly controlled alignment and safety standards.
Mechanical, electrical and piping installation across the full production line
Working alongside the client and OEM engineers, our team delivered end-to-end industrial installation services covering mechanical works, electrical installation and piping and welding. The mechanical scope included unloading, unpacking, positioning and levelling of all machinery and auxiliaries, with mill baseplate alignment held to within 30 microns and hydraulic torquing of mill housings up to 4,650 kN.
Unloading, unpacking, positioning and levelling of all machinery and auxiliaries, with baseplate alignment to within 30 microns |
Hydraulic torquing of mill housings up to 4,650 kN |
Cable laying and termination across 375 km, with cable tray fabrication, panel installation, earthing and system loop checks |
Fabrication and erection of hydraulic, pneumatic and lubrication piping, with installed pipework pressure-tested for leak integrity |
High-capacity lifting using 700-tonne and 250-tonne mobile cranes |
Unloading, unpacking, positioning and levelling of all machinery and auxiliaries, with baseplate alignment to within 30 microns |
Hydraulic torquing of mill housings up to 4,650 kN |
Cable laying and termination across 375 km, with cable tray fabrication, panel installation, earthing and system loop checks |
Fabrication and erection of hydraulic, pneumatic and lubrication piping, with installed pipework pressure-tested for leak integrity |
High-capacity lifting using 700-tonne and 250-tonne mobile cranes |
-
Unloading, unpacking, positioning and levelling of all machinery and auxiliaries, with baseplate alignment to within 30 microns
-
Hydraulic torquing of mill housings up to 4,650 kN
-
Cable laying and termination across 375 km, with cable tray fabrication, panel installation, earthing and system loop checks
-
Fabrication and erection of hydraulic, pneumatic and lubrication piping, with installed pipework pressure-tested for leak integrity
-
High-capacity lifting using 700-tonne and 250-tonne mobile cranes
Over 6,250 tonnes installed to the tolerances the mill required
The project delivered the complete mechanical installation of more than 6,250 tonnes of equipment and 375 km of electrical cabling, alongside the precision piping scope. Across the Cold Rolling Mill and finishing line, heavy-lift installation was coordinated with baseplate alignment held to within 30 microns.
Need to know more?
- Client: Metals manufacturer
- Location: India
- Sector: Metals
- Programme: Cold rolling mill and finishing line installation

Aluminium slab casting equipment installation in Belgium
- 40,000+ Project hours
- Lichtervelde, Belgium Location
- Metals & Minerals Sector

Greenfield aluminium plant installation in Kathua, Jammu
- 610 days Programme length
- 230 + 25 supervisors Workforce
- 1,400 tonnes Mill capacity

Main ram housing replacement on a 5,100-ton extrusion press
- 5,100 tons Extrusion press rating
- 400 tons Gantry capacity
- 17 Team size

Three extrusion press and ASRS installation programme in India
- 3 Extrusion presses
- 7, 8 and 10 inch Press sizes
- 150+ Planned team

4,400-ton extrusion press installation in the Southwest USA
- 4,400 tons Press
- 400 tons Gantry
- R120 forklift + hydraulic press cart Equipment

Production line relocation from Bulgaria to the Netherlands
- 2 Production lines
- furnaces + casting lines + transformers + cooling towers + pumps Main equipment
- cross-Europe Transport

HSE consultancy support for a major EV manufacturing facility in Saudi Arabia
- 10 months Programme length
- 100+ RAMS reviewed
- 500+ Observations closed

Automated tyre plant installation in Tangier, Morocco
- 70,560 Planned project hours
- 120 days Duration
- multiple Plant zones
