Dismantling an existing packaging line, including mechanical and electrical scope, inside an operating beverage-can facility ahead of a planned replacement installation.

Removing an existing packaging line inside an operational production facility
The long-term client needed an existing packaging line dismantled to create space for new technology while the surrounding production facility remained operational. The scope covered both mechanical and electrical elements of the line.
Complete line dismantling supported by specialist access equipment

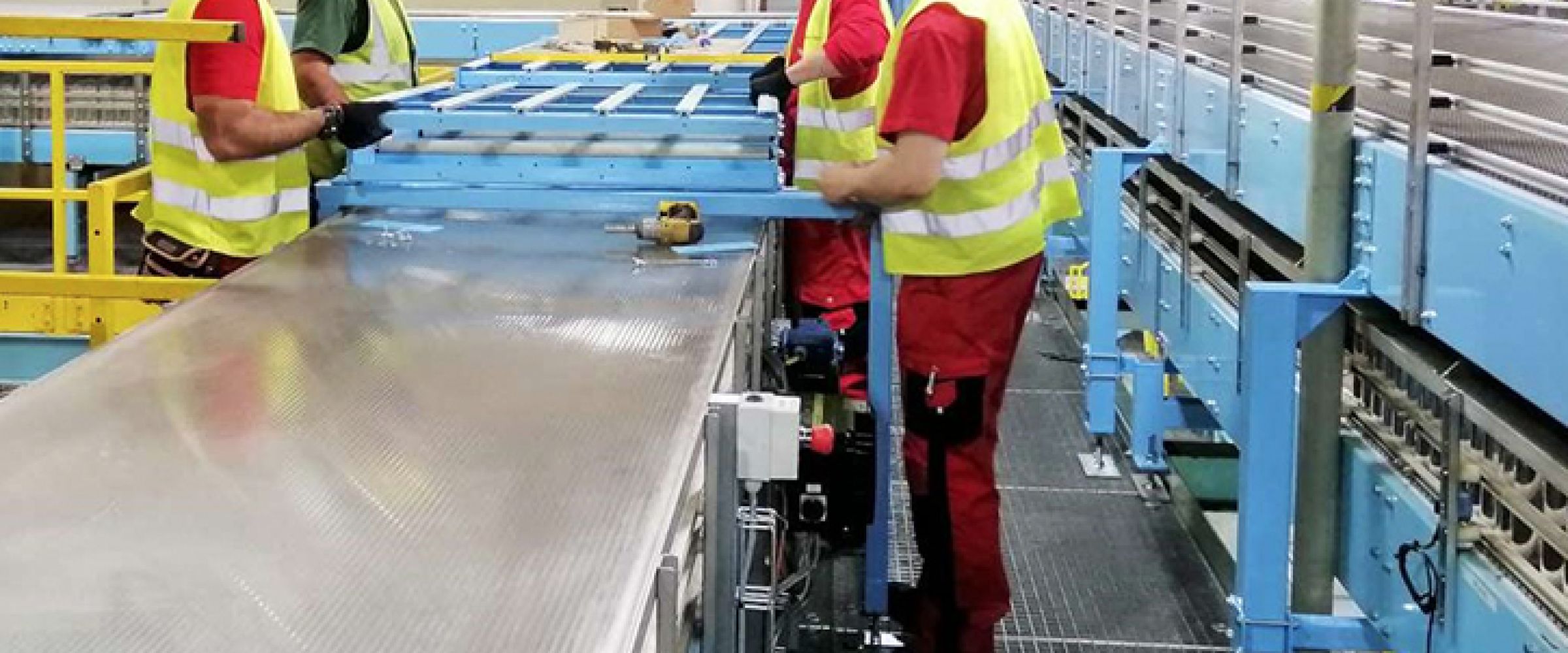

The dismantling work covered the existing packaging line, with specialist access equipment supporting the mechanical and electrical scope inside the operating facility.
The programme also included a planned follow-on replacement-line installation after the dismantling work.
Complete dismantling scope for the existing packaging line |
Mechanical and electrical work included |
Specialist access equipment used inside the facility |
Work planned within an operational production environment |
Replacement line installation planned as the following project phase |
Complete dismantling scope for the existing packaging line |
Mechanical and electrical work included |
Specialist access equipment used inside the facility |
Work planned within an operational production environment |
Replacement line installation planned as the following project phase |
-
Complete dismantling scope for the existing packaging line
-
Mechanical and electrical work included
-
Specialist access equipment used inside the facility
-
Work planned within an operational production environment
-
Replacement line installation planned as the following project phase
Dismantling followed by a planned replacement-line installation
The programme paired removal of the existing packaging line with a planned follow-on installation phase for its replacement.
- Client: Aluminium beverage-can manufacturer
- Location: Czech Republic
- Sector: Paper, Canning & Packaging
- Programme: Packaging line dismantling and replacement programme

Cardboard press removal under low-clearance and soft-ground conditions
- 91,000 lb New machine weight
- steel plates Ground control
- 3 lifts simultaneously Load management

Technical rigging & retrofit: integrating a Gigafactory with more than 3,500 assets
- 29,467 Project hours
- 117 days Duration
- 3,506 Items relocated

Hydraulic press dismantling completed in nine days
- 9 days Timeline
- 24/7 Shift pattern
- 35 tonnes Heaviest retained component

Four-press line dismantling for international transport
- 4 Presses dismantled
- 2,000 tons Largest press
- 16 weeks Timeline

Dismantling a 5-ton industrial oven using a 7-ton Hyster forklift
- 5 tons Oven weight
- 7 tons Forklift capacity
- Hyster S150 Forklift model

Fridge production line dismantling and relocation programme
- 2 Production lines
- 42 Vehicles deployed
- 10 Listed machines/components

Automotive body shop strip-out completed in 11 weeks
- ~800 tonnes Machinery removed
- 200+ Robots removed
- 11 weeks Timeline

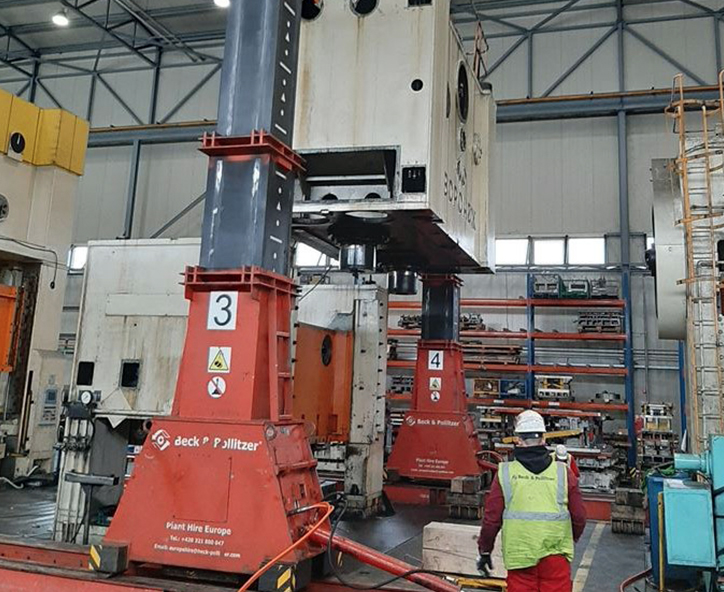

Komatsu forging press dismantling and removal in Hungary
- 2,500 Project hours
- 10 Team
- 500t Power tower
