Unloading, positioning and levelling a spray packaging production line within a roof clearance of only 40 cm.

Positioning production equipment beneath a roof structure with only 40 cm clearance
The packaging manufacturer required a spray packaging production line to be unloaded, moved to its installation area, positioned and levelled. The main physical constraint was the space below the roof structure, where only 40 cm of free clearance was available.
VersaLift, 7-tonne forklift and MEWP used for handling and positioning
The team managed the installation sequence from destination unloading and unpacking through to positioning, levelling and handover. A VersaLift 40/60, Hyster 7-tonne forklift and MEWP supported movement and access within the restricted area.
Health and safety planning formed part of the installation before the equipment was moved into position.
Destination unloading and unpacking from wooden boxes |
Internal movement to the installation location |
Machine manoeuvring, installation, positioning and levelling |
VersaLift 40/60, Hyster 7-tonne forklift and MEWP used during the work |
Health and safety planning and final handover |
Destination unloading and unpacking from wooden boxes |
Internal movement to the installation location |
Machine manoeuvring, installation, positioning and levelling |
VersaLift 40/60, Hyster 7-tonne forklift and MEWP used during the work |
Health and safety planning and final handover |
-
Destination unloading and unpacking from wooden boxes
-
Internal movement to the installation location
-
Machine manoeuvring, installation, positioning and levelling
-
VersaLift 40/60, Hyster 7-tonne forklift and MEWP used during the work
-
Health and safety planning and final handover
Production line installation completed on schedule across 1,580 project hours
The installation was completed on schedule after 1,580 project hours. The equipment was positioned and levelled within the restricted roof-clearance condition.
- Client: Packaging manufacturer
- Location: Czech Republic
- Sector: Paper, Canning & Packaging
- Programme: Spray packaging production line installation
- Timeline: Completed end of 2022

132,000 lb stamping press installation in South Carolina
- 132,000 lb Press weight
- 400 tons Gantry capacity
- 4 Team

Mechanical and electrical canning line installation in a live plant
- 79 Operatives
- ~60 tons Power and control cable
- ~15 tons Cable routes

Aluminium can production equipment installation in Chelyabinsk
- production equipment + steel structures + conveyors Scope
- compressed air, water, drain and vacuum Utilities

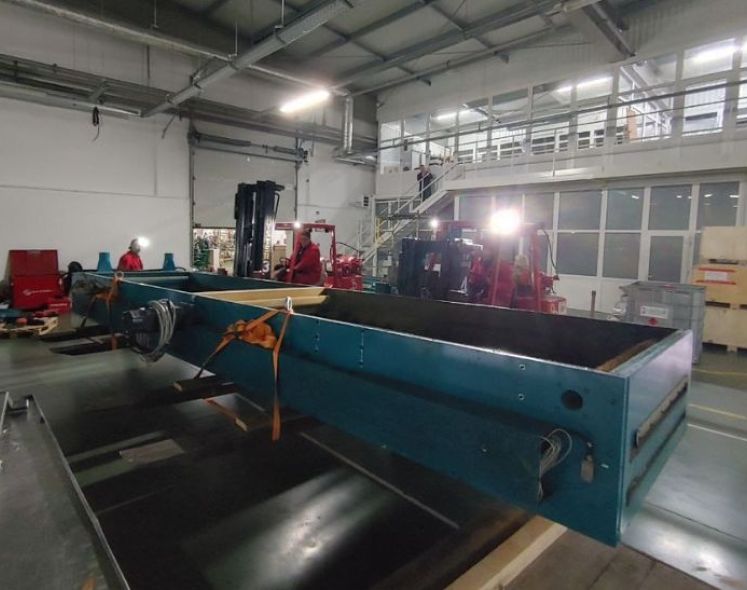

Laminating machine relocation in a space-constrained facility in Ukraine
- Nordmeccanica Duplex Combi Linear L1300 Equipment
- Ongoing Project status

Cosmetic bottling line relocation: Ohio to Texas
- 42 Components relocated
- 13,000+ lbs Heaviest component
- 4 weeks Timeline

Cardboard press removal under low-clearance and soft-ground conditions
- 91,000 lb New machine weight
- steel plates Ground control
- 3 lifts simultaneously Load management

Packaging line dismantling for new technology in the Czech Republic
- complete dismantling scope Existing line
- mechanical + electrical Disciplines
- operating production facility Environment

HSE consultancy support for a major EV manufacturing facility in Saudi Arabia
- 10 months Programme length
- 100+ RAMS reviewed
- 500+ Observations closed
