Dismantling and containerising a 180-tonne extrusion line, including a 130-tonne press, within five weeks.

Breaking down a 130-tonne press for transport within a compressed five-week programme
Our Australian team was asked to relocate an entire extrusion line within an expedited five-week programme. The line totalled 180 tonnes, with the main press alone weighing 130 tonnes. Lifting the main press without stripping it was an option, but logistical constraints and transport costs ruled it out, so the industrial relocation strategy centred on stripping the equipment into components.
Tandem 40-tonne cranes, hydraulic jacking and match-marked components packed into 27 containers
The team stripped the extrusion equipment into components, match-marked mechanical parts and labelled electrical wiring before packing the equipment into 27 40-foot containers. Heavy lifts were completed using tandem 40-tonne Franna cranes, hydraulic jacking and skates. Electrical disconnection and reconnection documentation was supplied to support later installation and commissioning at the destination. The project also included controlled oil removal and recycling in line with EPA compliance standards.
Dismantling and match-marking of the 180-tonne extrusion line |

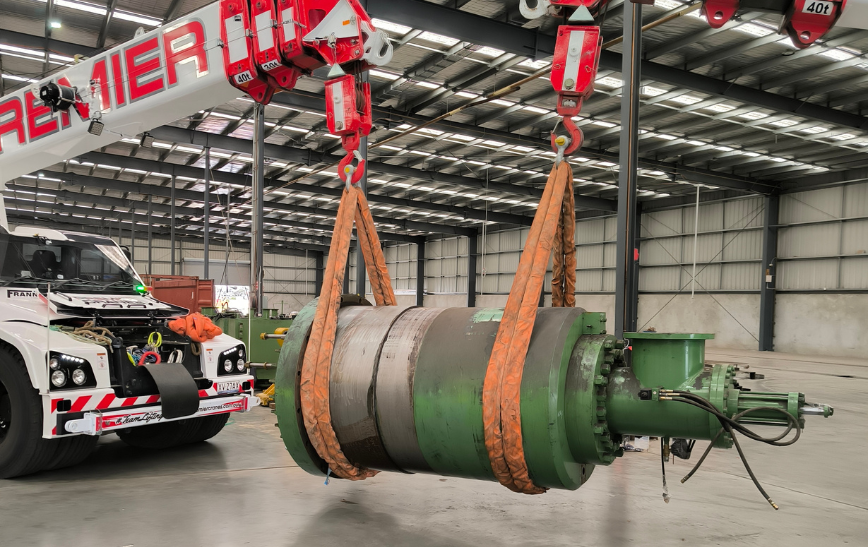

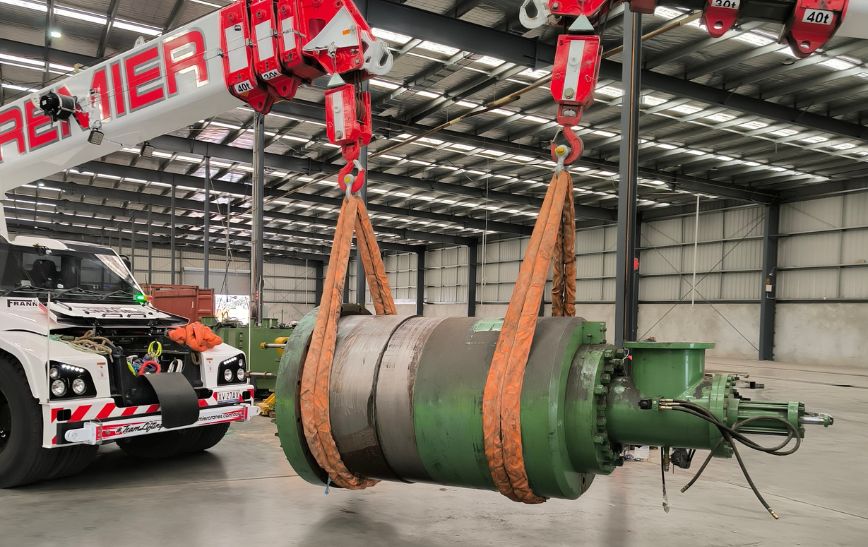

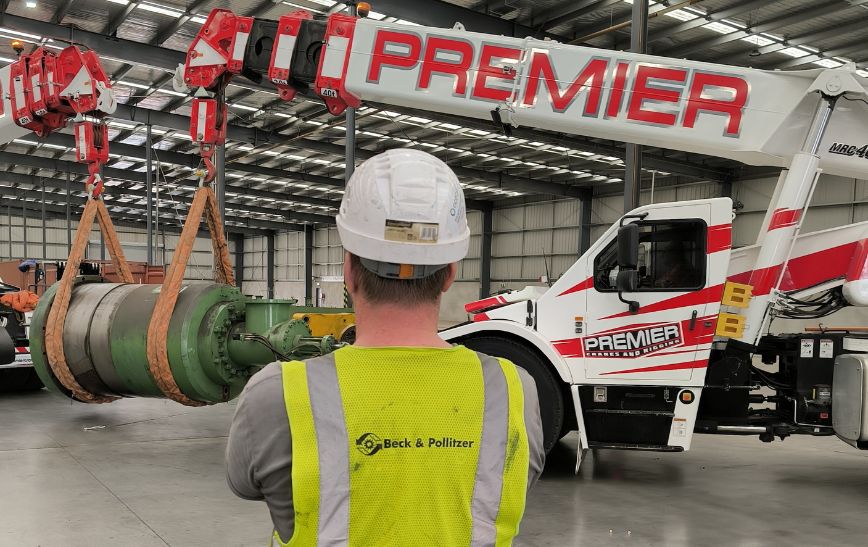

130-tonne main press stripped into transportable components |
Tandem lifting with 40-tonne Franna cranes |

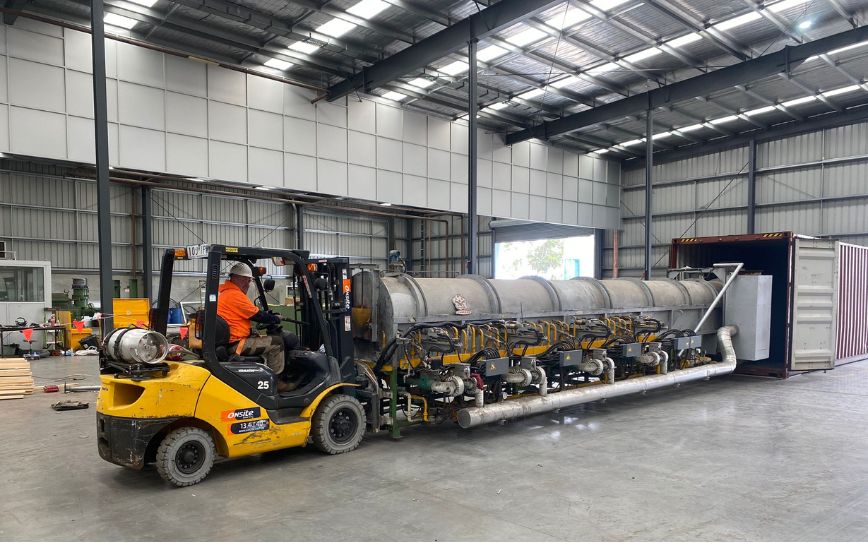

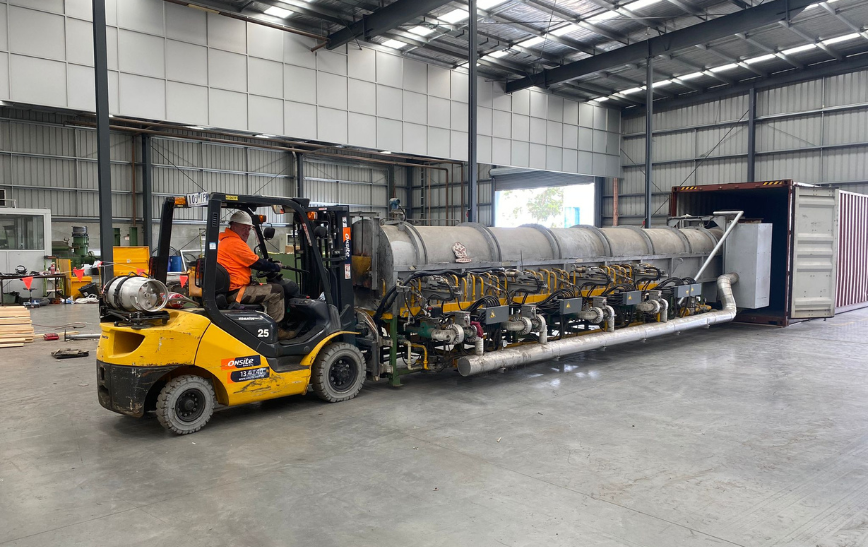

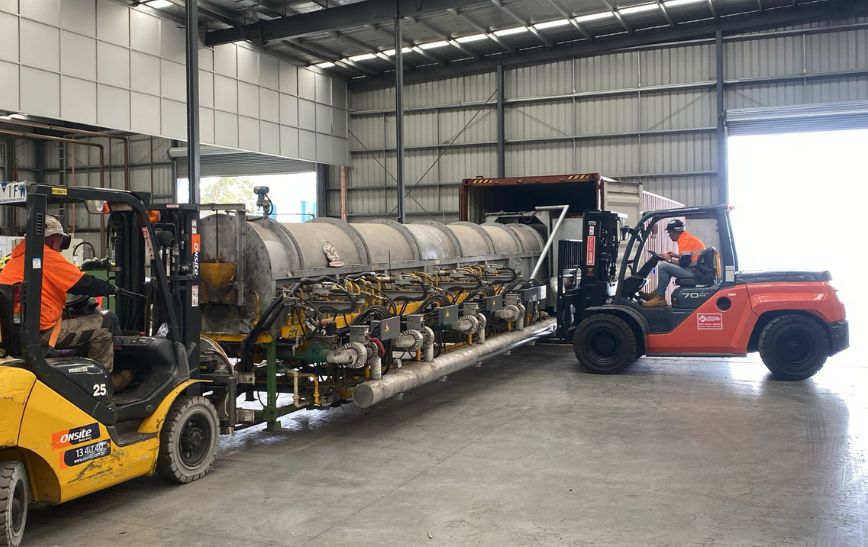

Hydraulic jacking and skates used for controlled heavy movement |
Twenty-seven 40-foot containers used for transport preparation |
Electrical components and wiring disconnected, labelled and documented for reconnection |
Oil removed, filtered and managed in line with EPA compliance standards |
Dismantling and match-marking of the 180-tonne extrusion line |
130-tonne main press stripped into transportable components |
Tandem lifting with 40-tonne Franna cranes |
Hydraulic jacking and skates used for controlled heavy movement |
Twenty-seven 40-foot containers used for transport preparation |
Electrical components and wiring disconnected, labelled and documented for reconnection |
Oil removed, filtered and managed in line with EPA compliance standards |
-
Dismantling and match-marking of the 180-tonne extrusion line
-
130-tonne main press stripped into transportable components
-
Tandem lifting with 40-tonne Franna cranes
-
Hydraulic jacking and skates used for controlled heavy movement
-
Twenty-seven 40-foot containers used for transport preparation
-
Electrical components and wiring disconnected, labelled and documented for reconnection
-
Oil removed, filtered and managed in line with EPA compliance standards
Extrusion line prepared for relocation within the five-week schedule
The Australian relocation scope was completed within the five-week programme, with zero reported Lost Time Incidents, Medical Treatment Incidents or property damage. The equipment was dismantled, documented and containerised for transport, including the 130-tonne main press.
Need to know more?
- Location: Australia
- Sector: Automotive
- Programme: Extrusion line relocation
- Timeline: 5 weeks

Cylinder head and block production line relocation: Poland to Brazil
- 50,000 Working hours
- 337 Trucks dispatched
- 2 Production lines relocated

Fuel injection pump production line move: Germany to Czech Republic
- 2 Production lines
- 30 Trucks
- 3-ton Forklifts

Automated stamping machine relocation for an automotive technology supplier
- project manager, assembly supervisor and around 10 skilled workers Core team
- relocation through to commissioning Scope
- weekly with the client Planning

Relocation of 31 machines across four automotive halls in Hungary
- 31 Machines relocated
- 4 Industrial halls
- 2,000+ m² Area

Staged automotive machinery relocation from Germany to Hungary
- 3,000 Project hours
- 10 Relocation stages
- mechanical + electrical + transport Scope

Mild-hybrid underbody line installation for an automotive manufacturer
- 2,100 Project hours
- 13 operatives Team
- no reported incidents or accidents Safety outcome

Heavy machinery relocation from Poland to India in three shipping batches
- ~80 tonnes Total equipment weight
- ~8-10 tonnes Individual machines
- 3 Shipping batches

Machinery relocation from Hungary to Slovakia
- 5 weeks Timeline
- 2 Countries
- COVID restrictions + strict schedule Constraints
