Autostore installation for a clothing distribution centre in North Carolina

Installing service mezzanines, 1,444 grid cells and 36 robots after an incomplete site forced a two-month demobilisation.

USA

The Challenge

Restarting an Autostore installation after the site was suspended on day one

The Greensboro project covered a goods-to-person Autostore system with complete mechanical and electrical installation. The planned start was suspended on the same day because the site was incomplete.

Beck & Pollitzer then loaded, transported and stored the project equipment and materials until work could restart. The project remained demobilised for two months before resuming in mid-August.


Our Solution

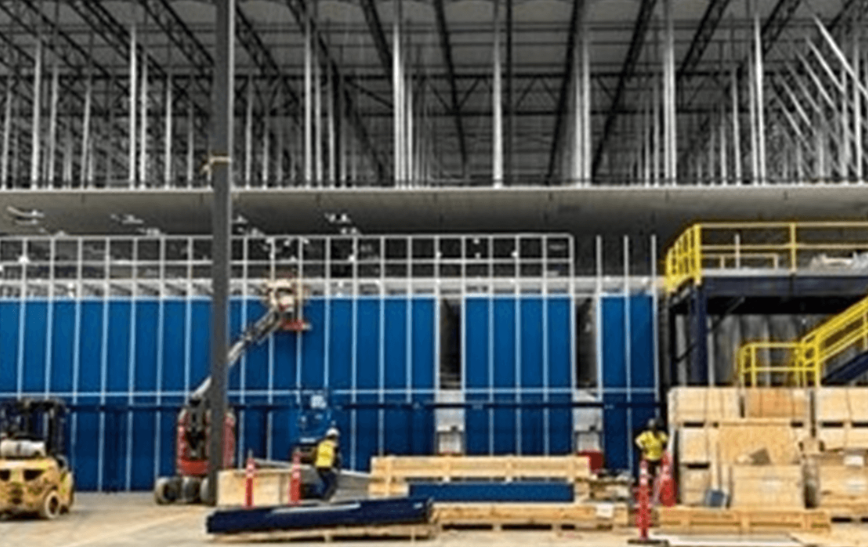

Equipment storage and remobilisation followed by mezzanine, grid and robot installation

After the suspension, the team managed the equipment and materials off site until remobilisation. Once work resumed, the installation scope included service and overhang mezzanines, 1,444 grid cells and 36 robots.

The installation scope was mechanical and electrical, with the work executed safely following the delayed launch.

Project equipment and materials loaded, transported and stored after site suspension
Two-month demobilisation before work restarted
Service and overhang mezzanine assembly
1,444 Autostore grid cells
36 robots
Mechanical and electrical installation
Project equipment and materials loaded, transported and stored after site suspension
Two-month demobilisation before work restarted
Service and overhang mezzanine assembly
1,444 Autostore grid cells
36 robots
Mechanical and electrical installation
Project equipment and materials loaded, transported and stored after site suspension
Two-month demobilisation before work restarted
Service and overhang mezzanine assembly
1,444 Autostore grid cells
36 robots
Mechanical and electrical installation
Project equipment and materials loaded, transported and stored after site suspension
Two-month demobilisation before work restarted
Service and overhang mezzanine assembly
1,444 Autostore grid cells
36 robots
Mechanical and electrical installation
  • Project equipment and materials loaded, transported and stored after site suspension
  • Two-month demobilisation before work restarted
  • Service and overhang mezzanine assembly
  • 1,444 Autostore grid cells
  • 36 robots
  • Mechanical and electrical installation

The Outcome

Installation restarted after a two-month demobilisation

Work restarted in mid-August after a two-month demobilisation, with completion planned for early October.

Grid cells
1,444
Robots
36
Systems
service + overhang mezzanines
Delay
two-month demobilisation after site suspension
Project Details
  • Client: Clothing distribution centre operator
  • Location: Greensboro, North Carolina, USA
  • Sector: Warehouse Automation; Consumer Goods
  • Programme: Autostore mechanical and electrical installation
  • Timeline: Two-month demobilisation; restarted mid-August with completion planned for early October

Related Projects

Beck & Pollitzer Industrial Intelligence™

Industrial insight drawn from real-world delivery. Explore reports, articles and expert perspectives on the challenges shaping modern manufacturing and industrial programmes.
What manufacturers should consider before relocating production →
8 min

What manufacturers should consider before relocating production →

5 min read

What manufacturers should consider before relocating production →

5 min read

Your next project starts here

Whether you’re exploring an opportunity, planning a facility or preparing for installation,
our specialists can help you take the next step with confidence.
This site is registered on wpml.org as a development site. Switch to a production site key to remove this banner.
