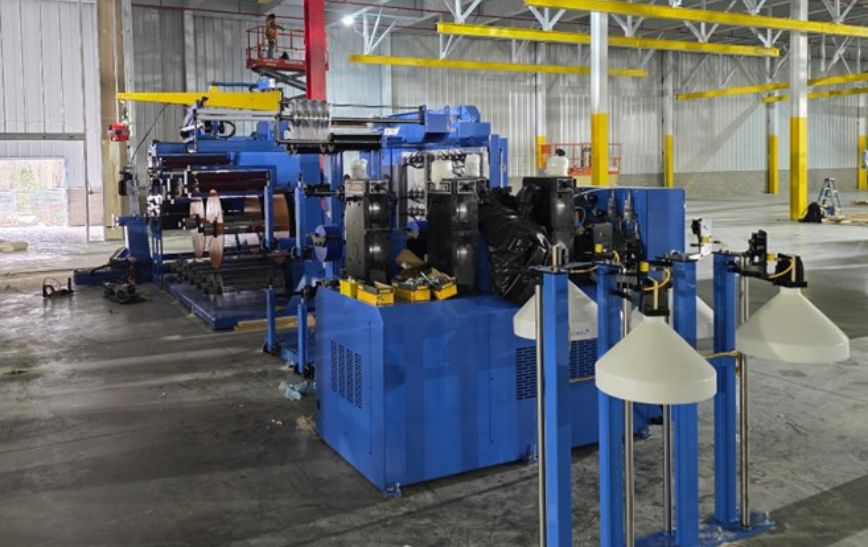

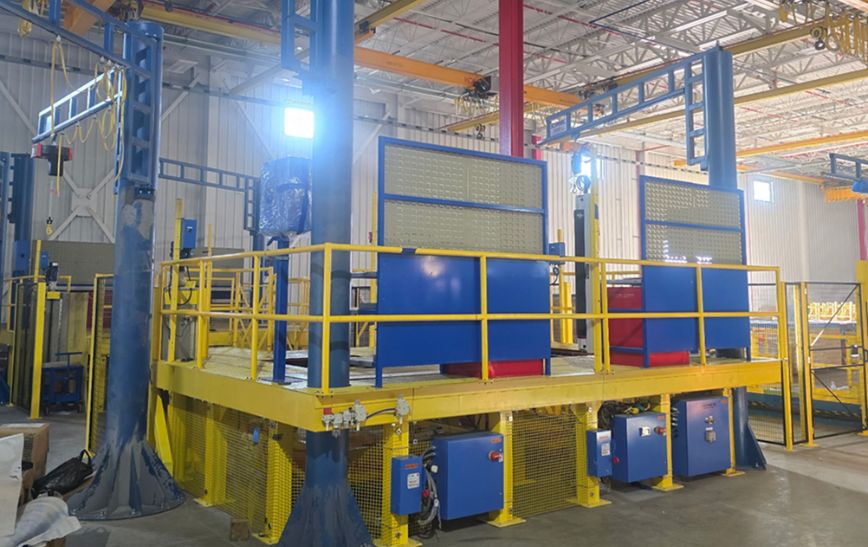

Installing 275 machines across a 250,000-square-foot manufacturing plant over an eight-month programme.

The Challenge
Integrating 275 machines across a new 250,000-square-foot facility
Beck & Pollitzer carried out the complete setup of a new voltage regulator production facility for a global power management company, covering a 250,000-square-foot manufacturing plant over an eight-month programme valued at over $4 million. The installation had to integrate 275 machines across sheet metal fabrication, assembly, testing and logistics.
Our Solution
275 machines integrated across sheet metal, assembly, and logistics systems
Our team delivered the full installation scope for the new production lines, including machinery installation, process piping and electrical integration. The scope covered the integration of 275 machines across a wide variety of manufacturing processes essential to voltage regulator production.
Sheet metal fabrication: laser cutting equipment with automated magazine systems, precision forming and punching presses, welding stations and automated material handling |
Assembly and testing infrastructure: coil winding, stacking and brazing systems, precision filling and vacuum processing, electrical test cells and quality assurance stations |
Logistics and material handling: jib cranes, overhead cranes, free-standing lifting systems, conveyance systems, forklifts and plug-in vehicle charging systems |
Sheet metal fabrication: laser cutting equipment with automated magazine systems, precision forming and punching presses, welding stations and automated material handling |
Assembly and testing infrastructure: coil winding, stacking and brazing systems, precision filling and vacuum processing, electrical test cells and quality assurance stations |
Logistics and material handling: jib cranes, overhead cranes, free-standing lifting systems, conveyance systems, forklifts and plug-in vehicle charging systems |
-
Sheet metal fabrication: laser cutting equipment with automated magazine systems, precision forming and punching presses, welding stations and automated material handling
-
Assembly and testing infrastructure: coil winding, stacking and brazing systems, precision filling and vacuum processing, electrical test cells and quality assurance stations
-
Logistics and material handling: jib cranes, overhead cranes, free-standing lifting systems, conveyance systems, forklifts and plug-in vehicle charging systems
The Outcome
275 machines installed within an eight-month programme
The installation integrated 275 machines across the new 250,000-square-foot facility within the eight-month programme valued at more than $4 million. The completed scope brought sheet metal fabrication, assembly and testing equipment, process services and material-handling systems into one coordinated production facility.
Need to know more?
- Client: Power management company
- Location: USA
- Sector: Battery and Electrification
- Programme: Voltage regulator production facility installation
- Timeline: 8 months

HSE consultancy support for a major EV manufacturing facility in Saudi Arabia
- 10 months Programme length
- 100+ RAMS reviewed
- 500+ Observations closed

Scalable M&E installation: Automated storage & handling for a US battery facility
- 111,328 Project hours
- 15 months Programme length
- 100 Peak workforce

Solar glass manufacturing line installation at a renewable energy gigafactory in India
- 6,000+ acres Facility size
- Solar glass, solar PV, battery cells, green hydrogen Production lines on site

Body shop installation for a new EV plant in India
- nearly 100 Containers unloaded
- 30 Trucks
- 50 Site team

EV manufacturing installation and process utility integration in India
- 10 months Programme duration
- 120 Site team
- 4 Towers erected

Battery cell plant electrical installation in France
- 45,000 Project hours
- 18 months Duration
- electrical integration and installation Scope

Body-in-white installation for an electric vehicle programme
- body sides + final hang-on line + roller tables + lift systems Scope
- compressed design-to-build schedule Constraint

45-tonne NMP recovery unit installation under restricted headroom
- 20,000 kg NMP unit
- 45,000 kg Fully assembled lift
- 20 m x 8 m Mezzanine
