Bringing a new aluminium rolling and casting plant online for an Asian aluminium manufacturing specialist.

The Challenge
230 workers, 610 days, one accountable team
A greenfield metals plant depends on getting its heaviest, most sensitive equipment right first, since everything downstream relies on it. Beck & Pollitzer supported an Asian aluminium manufacturing specialist with exactly that scale of installation, delivering the full range of industrial installation services needed to bring a new aluminium rolling and casting plant online in Kathua, Jammu.
Over a sustained 610-day programme, a dedicated on-site team of 230 workers plus 25 supervisors and engineers carried out the installation and commissioning of every piece of production machinery on site.
Our Solution
1,400-tonne mill, four casting lines, one commissioning handover
Cold Rolling Mill | 1,400-tonne mill positioned and anchored to OEM specification |
Casting lines | Four combined lines, 1,300-tonne combined capacity |

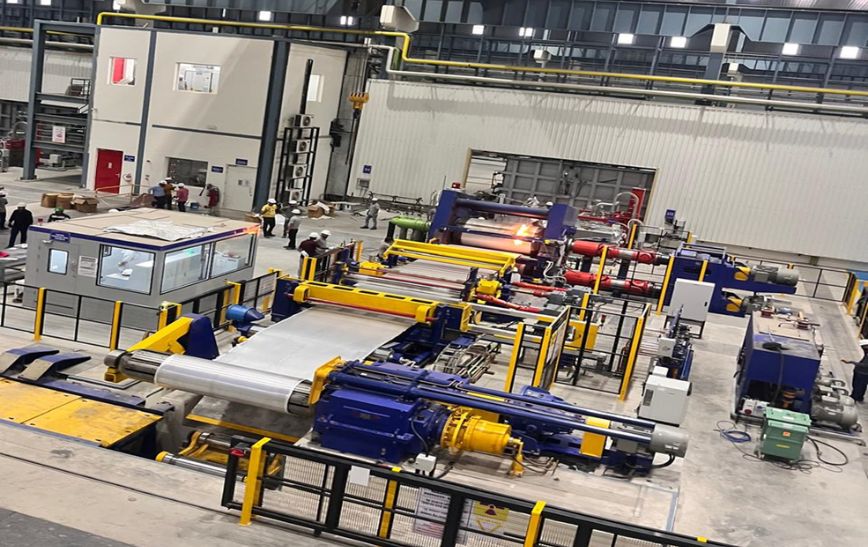

Finishing equipment | Roll Grinder, Slitter and Cut-to-Length (CTL) lines installed and aligned |
Structural & electrical | 110 tonnes of steel cladding, plus main power cabling, trays and panel installation |
Cold Rolling Mill | 1,400-tonne mill positioned and anchored to OEM specification |
Casting lines | Four combined lines, 1,300-tonne combined capacity |
Finishing equipment | Roll Grinder, Slitter and Cut-to-Length (CTL) lines installed and aligned |
Structural & electrical | 110 tonnes of steel cladding, plus main power cabling, trays and panel installation |
-
1,400-tonne mill positioned and anchored to OEM specification
-
Four combined lines, 1,300-tonne combined capacity
-

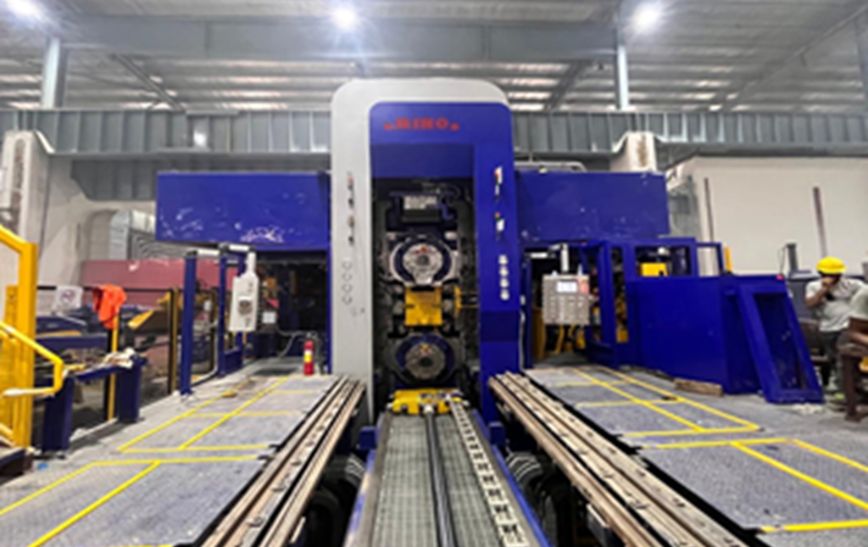

Roll Grinder, Slitter and Cut-to-Length (CTL) lines installed and aligned
-
110 tonnes of steel cladding, plus main power cabling, trays and panel installation

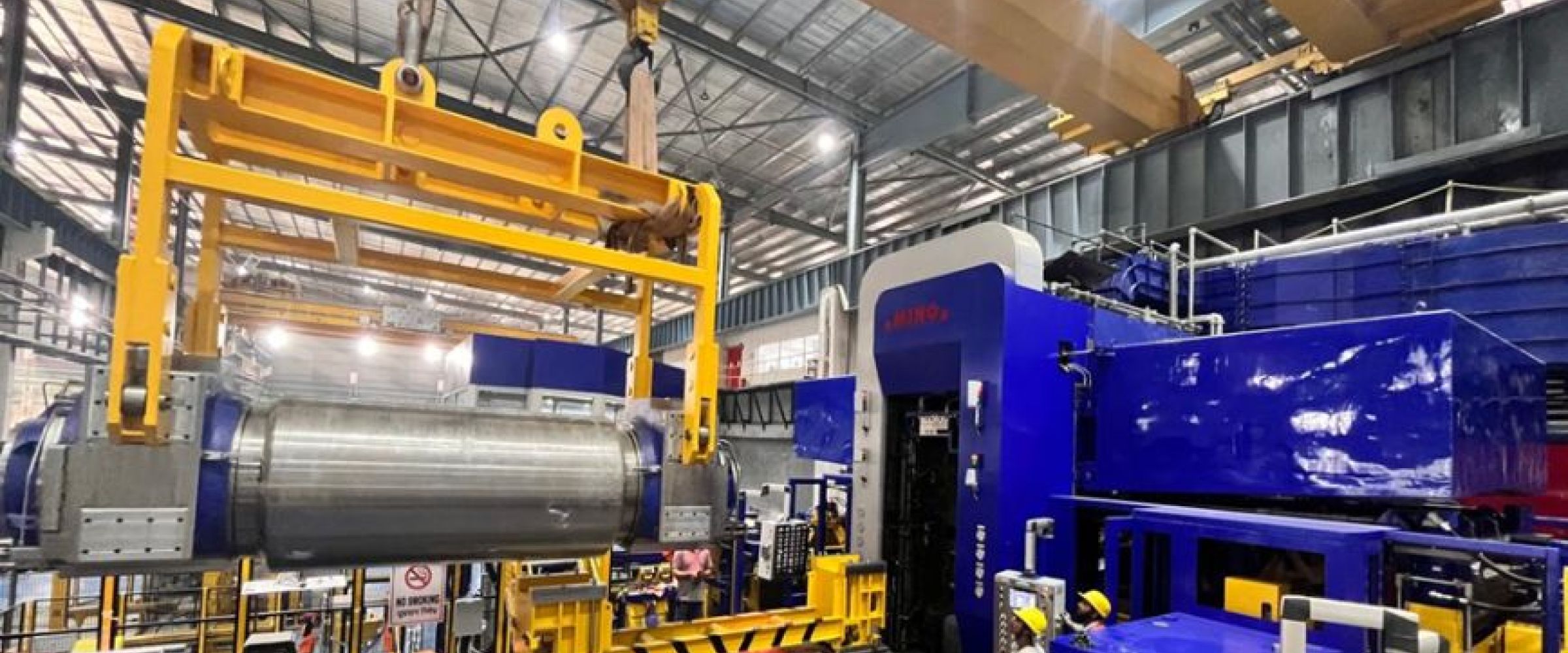

Mobile cranes of up to 300 tonnes supported the safe placement of the Mill and Caster housings, with piping systems, including hydraulic, lubrication and rolling oil lines, fabricated and leak-tested to specification. Following the mechanical and electrical build-out, Beck & Pollitzer worked directly with OEM teams to complete commissioning and bring the plant to full operational status.
The Outcome
230 workers plus 25 supervisors, 610 days, full handover
With mechanical, electrical, structural and piping scopes delivered as one integrated programme, the plant reached full operational status through joint commissioning with the equipment OEMs.
The result gave the client a fully operational aluminium rolling and casting plant, brought online through a single, accountable delivery team across the full 610-day programme.
Need to know more?
- Client: Asian aluminium manufacturing specialist (not named in source)
- Location: Kathua, Jammu, India
- Sector: Metals & Minerals
- Programme: Machinery installation, rigging & commissioning
- Timeline: 610 days (~19 months)

Aluminium slab casting equipment installation in Belgium
- 40,000+ Project hours
- Lichtervelde, Belgium Location
- Metals & Minerals Sector

Mechanical installation for a new cold rolling mill and finishing line
- 6,250+ tonnes Equipment installed
- 375 km Electrical cabling
- 30 microns Baseplate alignment tolerance

Main ram housing replacement on a 5,100-ton extrusion press
- 5,100 tons Extrusion press rating
- 400 tons Gantry capacity
- 17 Team size

Three extrusion press and ASRS installation programme in India
- 3 Extrusion presses
- 7, 8 and 10 inch Press sizes
- 150+ Planned team

4,400-ton extrusion press installation in the Southwest USA
- 4,400 tons Press
- 400 tons Gantry
- R120 forklift + hydraulic press cart Equipment

Production line relocation from Bulgaria to the Netherlands
- 2 Production lines
- furnaces + casting lines + transformers + cooling towers + pumps Main equipment
- cross-Europe Transport

HSE consultancy support for a major EV manufacturing facility in Saudi Arabia
- 10 months Programme length
- 100+ RAMS reviewed
- 500+ Observations closed

Automated tyre plant installation in Tangier, Morocco
- 70,560 Planned project hours
- 120 days Duration
- multiple Plant zones
