Moving heavy and sensitive solar-manufacturing equipment through narrow internal routes before skating, positioning and precision alignment.

The Challenge
Moving heavy, sensitive equipment through narrow areas inside the manufacturing hall
The solar-panel manufacturing project required heavy and sensitive machine elements to be unloaded, manoeuvred through narrow internal routes and moved deep into the customer’s manufacturing hall.
Once in the installation area, the machinery needed accurate positioning and alignment before start-up.
Our Solution
Internal manoeuvring, skidding and alignment using precision equipment

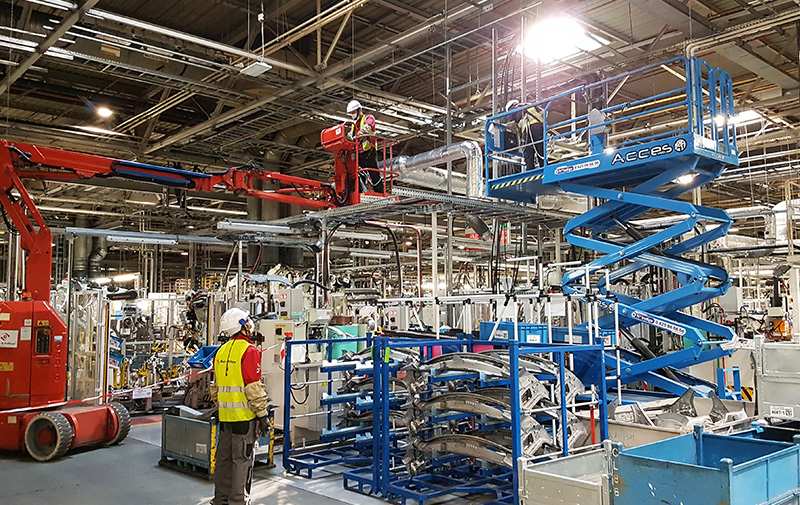

The Hungary team took responsibility from truck and trailer unloading through internal manipulation and final positioning. Equipment was moved through the restricted routes, skated into place and then adjusted and aligned using Beck & Pollitzer precision equipment.
Truck and trailer unloading |
Internal manoeuvring through narrow areas |
Skating equipment into final position |
Final adjustment and precision alignment before start-up |
Truck and trailer unloading |
Internal manoeuvring through narrow areas |
Skating equipment into final position |
Final adjustment and precision alignment before start-up |
-
Truck and trailer unloading
-
Internal manoeuvring through narrow areas
-
Skating equipment into final position
-
Final adjustment and precision alignment before start-up
The Outcome
Solar-manufacturing equipment installed and aligned
The machinery installation was completed, with the equipment moved into position and aligned before start-up.
- Client: Solar-panel manufacturer
- Location: Hungary
- Sector: Battery and Electrification; Other Industries
- Programme: Precision machinery installation

HSE consultancy support for a major EV manufacturing facility in Saudi Arabia
- 10 months Programme length
- 100+ RAMS reviewed
- 500+ Observations closed

Scalable M&E installation: Automated storage & handling for a US battery facility
- 111,328 Project hours
- 15 months Programme length
- 100 Peak workforce

Voltage regulator production facility installation in the USA
- 275 Machines installed
- 250,000 sq ft Facility size
- 8 months Programme duration

Solar glass manufacturing line installation at a renewable energy gigafactory in India
- 6,000+ acres Facility size
- Solar glass, solar PV, battery cells, green hydrogen Production lines on site

Body shop installation for a new EV plant in India
- nearly 100 Containers unloaded
- 30 Trucks
- 50 Site team

EV manufacturing installation and process utility integration in India
- 10 months Programme duration
- 120 Site team
- 4 Towers erected

Battery cell plant electrical installation in France
- 45,000 Project hours
- 18 months Duration
- electrical integration and installation Scope

Technical rigging & retrofit: integrating a Gigafactory with more than 3,500 assets
- 29,467 Project hours
- 117 days Duration
- 3,506 Items relocated
