Installation of two vertical presses in the Czech Republic

Installing 103-ton and 43-ton vertical presses over ten days with a PT5400 gantry and dedicated SHEQ oversight.

Czech Republic

The Challenge

Positioning two multi-tonne presses onto prepared bases within a fixed ten-day window

The project required two vertical presses, weighing 103 tons and 43 tons, to be unloaded, turned into the vertical position and placed onto prepared bases at an international technology partner’s plant in Frýdlant nad Ostravicí. The installation had to be completed within ten days, and followed an earlier vertical press installation by Beck & Pollitzer for the same client.


Our Solution

PT5400 gantry and 8t forklift used for controlled lifting and placement

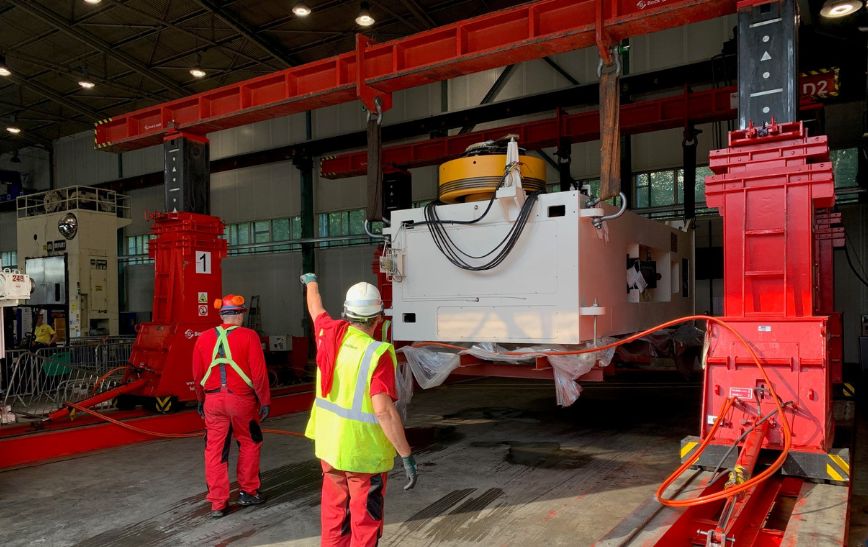

Our Czech team managed the heavy machinery installation, from unloading through vertical positioning to final placement on the prepared bases. A PT5400 gantry, an 8t Linde forklift and a cherry picker were used for the work. A project engineer, SHEQ manager and supervisor led four mechanical fitters, with the crew working ten hours each day and Health & Safety oversight in place throughout.

Unloading and handling of two vertical presses weighing 103 tons and 43 tons
Vertical positioning and placement onto prepared machine bases
PT5400 gantry, 8t Linde forklift and cherry picker deployed
Site team comprising one Project Engineer, one SHEQ Manager, one Supervisor and four Mechanical Fitters
Dedicated Health & Safety oversight throughout the lifting and positioning work
Unloading and handling of two vertical presses weighing 103 tons and 43 tons
Vertical positioning and placement onto prepared machine bases
PT5400 gantry, 8t Linde forklift and cherry picker deployed
Site team comprising one Project Engineer, one SHEQ Manager, one Supervisor and four Mechanical Fitters
Dedicated Health & Safety oversight throughout the lifting and positioning work
Unloading and handling of two vertical presses weighing 103 tons and 43 tons
Vertical positioning and placement onto prepared machine bases
PT5400 gantry, 8t Linde forklift and cherry picker deployed
Site team comprising one Project Engineer, one SHEQ Manager, one Supervisor and four Mechanical Fitters
Dedicated Health & Safety oversight throughout the lifting and positioning work
Unloading and handling of two vertical presses weighing 103 tons and 43 tons
Vertical positioning and placement onto prepared machine bases
PT5400 gantry, 8t Linde forklift and cherry picker deployed
Site team comprising one Project Engineer, one SHEQ Manager, one Supervisor and four Mechanical Fitters
Dedicated Health & Safety oversight throughout the lifting and positioning work
  • Unloading and handling of two vertical presses weighing 103 tons and 43 tons
  • Vertical positioning and placement onto prepared machine bases
  • PT5400 gantry, 8t Linde forklift and cherry picker deployed
  • Site team comprising one Project Engineer, one SHEQ Manager, one Supervisor and four Mechanical Fitters
  • Dedicated Health & Safety oversight throughout the lifting and positioning work

The Outcome

Both presses installed on schedule within the ten-day programme

The two vertical presses were installed within the planned ten-day period. The international technology partner gave positive feedback, extending a working relationship established on an earlier press installation.

Presses installed
2
Press weights
103 tons and 43 tons
Working day
10 hours
Core site team
7

Need to know more?

What equipment was used for the press installation?
A PT5400 gantry, an 8t Linde forklift and a cherry picker were used to unload, position and place the 103-ton and 43-ton presses.
How was the installation team structured?
The seven-person core team comprised a project engineer, SHEQ manager and supervisor alongside four mechanical fitters, with Health & Safety oversight forming part of the on-site team.
Project Details
  • Client: International technology partner
  • Location: Frýdlant nad Ostravicí, Czech Republic
  • Sector: Other Industries
  • Programme: Heavy machinery installation
  • Timeline: 10 days

Related Projects

Beck & Pollitzer Industrial Intelligence™

Industrial insight drawn from real-world delivery. Explore reports, articles and expert perspectives on the challenges shaping modern manufacturing and industrial programmes.
What manufacturers should consider before relocating production →
8 min

What manufacturers should consider before relocating production →

5 min read

What manufacturers should consider before relocating production →

5 min read

Your next project starts here

Whether you’re exploring an opportunity, planning a facility or preparing for installation,
our specialists can help you take the next step with confidence.
This site is registered on wpml.org as a development site. Switch to a production site key to remove this banner.
